Why Your Site Runs Out of Skip Space Every Thursday Morning

The Thursday Morning Crisis You Can See Coming on Wednesday

Experienced site managers often know by Wednesday lunchtime that the skip is going to be a problem. The signs are there: plasterers finishing their first board run, a curtain-wall delivery stacked at the gate, the first-fix spark clearing up his offcuts. Yet despite every signal pointing to the same outcome, around 60% of emergency skip requests still land on Thursday mornings, when plastering waste, packaging from mid-week deliveries, and first-fix debris all arrive in the same skip at the same time.

The frustrating part is that this is not bad luck. It is a predictable pattern that repeats week after week on residential conversions, commercial refurbishments, and multi-trade new builds alike. The sites change, but the timing rarely does. Treating it as a random emergency is what costs you the afternoon concrete pour, the variation order argument with the client, and the quiet loss of credibility with the groundworkers who turn up to find nowhere to put their rubble.

What the Mid-Week Waste Surge Actually Is

The mid-week waste surge is not simply a busy period. It is what happens when three or four separate trades complete major phases simultaneously between Tuesday afternoon and Thursday morning, generating concentrated waste volumes that a single skip, sized to an average weekly load, cannot absorb.

On a straightforward residential conversion, first-fix electrical and plumbing typically complete on Tuesday or Wednesday. Cable offcuts, pipe sections, conduit packaging, and the cardboard from consumer-unit boxes all go into the same skip. Second-fix carpentry is often running alongside, producing timber offcuts, plasterboard waste, and polystyrene from window deliveries. Then the Tuesday and Wednesday deliveries for the next phase arrive, bringing their own cardboard and wrapping. By Thursday morning, a single eight-yard skip that looked adequate at the start of the week is overflowing before the subbies have even signed in.

On larger sites, demolition phases finishing mid-week compound the problem further. Inert waste such as brick rubble and broken aggregates sits alongside mixed construction waste and packaging. A skip specification that made sense for average conditions falls apart under the concentrated load of a phase transition.

Why This Causes Real Operational Damage

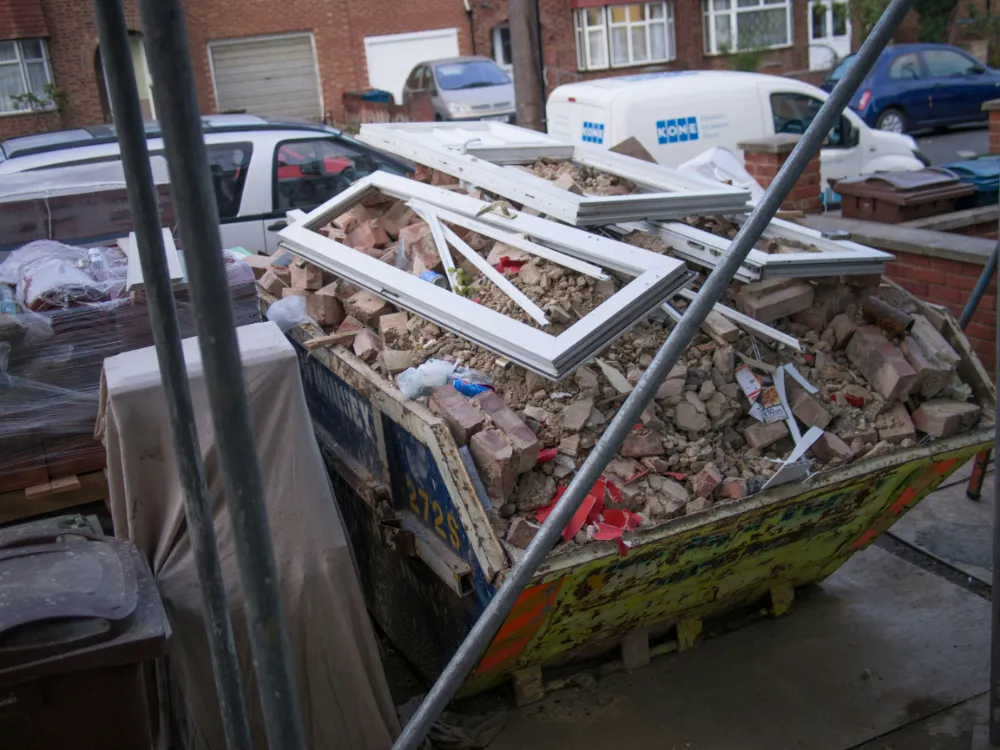

A blocked or overflowing skip is more than an eyesore. When waste accumulates in walkways, it triggers Health and Safety concerns that can stop work entirely. When a skip blocks the access route for a concrete pour, the afternoon’s programme goes with it. The concrete contractor charges a standing time, the pour is rescheduled, and the knock-on delays cascade through dependent tasks until the handover date is quietly moving back.

The financial damage is direct. Emergency skip costs appear on variation orders, clients ask why this was not anticipated, and the answer is difficult to give without implying poor planning. Subcontractors who arrive to find no disposal space either down tools or start storing waste materials unsafely, creating further Health and Safety risk and the friction that follows.

Beyond the immediate costs, there is a slower erosion of trust. A site manager who repeatedly runs out of skip space by Thursday morning earns a reputation that follows them across projects. The managers who avoid this reputation are not luckier; they have simply recognised the pattern.

Why the Pattern Keeps Getting Missed

Initial skip size calculations almost always follow the same logic: take the total project waste estimate, divide by the number of weeks on site, and book accordingly. This produces a reasonable average figure that bears no relationship to how waste actually arrives on site.

Procurement teams booking skips rarely consult the detailed trade programme. They do not see that week four has three trade completions overlapping, or that the main materials delivery falls on the same Tuesday as first-fix completion. Standard exchange schedules assume steady waste generation, which construction sites almost never produce.

Site managers inherit these arrangements at the start of a project. In the early weeks, they are focused entirely on trade coordination, programme management, and keeping the access clear. Waste flow patterns are the last thing on the list. By the time the first Thursday crisis hits, the arrangement is already set, the skip company has a regular slot booked, and changing it mid-project feels like extra work on top of an already full day.

The cycle repeats. A few emergency calls get made. The crisis is resolved, the week moves on, and the underlying scheduling gap stays in place.

How to Identify the Pattern on Your Current Project

The quickest method is to review your last six projects and mark when emergency skip requests occurred. If Thursday or Friday morning appears repeatedly, overlay your programme against those weeks. Check which trade completions or delivery days fell in the preceding 48 hours. The correlation is usually obvious once you look for it.

For your current project, check whether plastering phases, first-fix completions, or major materials deliveries cluster mid-week. Calculate waste volumes by trade phase rather than total project volume, and map those phases against your programme. Where two or three phases overlap in the same 72-hour window, that is your surge period.

The solution is not always a permanent second skip. Sometimes it is a planned exchange on Wednesday afternoon instead of Friday. Sometimes it is a larger skip size for the specific weeks where phase transitions coincide. The key is making the decision on Monday, not on Thursday morning from a mobile standing next to an overflowing skip.

How Programme-Aligned Skip Hire Changes the Week

The difference between reactive and proactive skip management is largely a scheduling conversation that happens before the programme starts, not after the first crisis. ISL Waste Services provides skip hire in Birmingham with exchange schedules built around trade programmes rather than arbitrary weekly slots. That means positioning additional capacity during predicted surge periods without locking sites into permanent dual-skip costs they do not need for quieter phases.

ISL Waste Services operates from its Tyseley depot, which means responsive Thursday morning exchanges are genuinely possible when programmes shift unexpectedly. Site managers call a local team that understands construction timelines, not a national call centre working from a script. That practical local knowledge makes a difference at 7:30 on a Thursday morning when you need a decision, not a callback window.

Proper waste transfer documentation is provided for every exchange, tracking volumes by collection. Over a project, this data helps refine skip size estimates for future schemes and demonstrates the duty of care that protects you under the Environmental Protection Act 1990. It removes the administrative burden of chasing paperwork and keeps your waste transfer notes in order without extra effort on your part.

Make It a Planning Task, Not a Crisis Response

The mid-week waste surge is a programme event. It follows your trade sequence as reliably as the sequence itself. Once you map it, you can plan for it with the same discipline you apply to concrete pours, inspection dates, and subcontractor scheduling.

Sites that plan skip capacity around trade overlap periods do not have Thursday morning capacity crises. They have Wednesday afternoon exchanges that are already booked. The cost difference between a planned exchange and an emergency call-out is significant; the reputational difference is larger still.
